so since i last posted our house has started and nearly at lock up! heres our time frames so far:
tender: 14/02/2012
contract: 02/03/2012
start delayed, waiting for council approval to build 4.5m from the crossover rather than 5m like our neighbours.
week 1 16/04/12: start today (18/04/12)
week 2 23/04/12: services in and site scraped
week 3 30/04/12: nothing, rain, rain go away!
week 4 07/05/12: base poured, yeahy. (9/05/12)

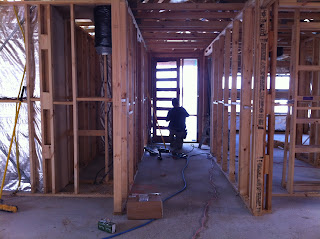

week 5 14/05/12: frame done, steaming ahead, plumbing roughed in (17/05/12)
week 6 21/05/12: roof on, solar panel up
week 7 28/05/12: lock up baby, bojarkus is fitting the doors and straightening the walls. air con and heating in, house is wrapped, top hats for hebel done.

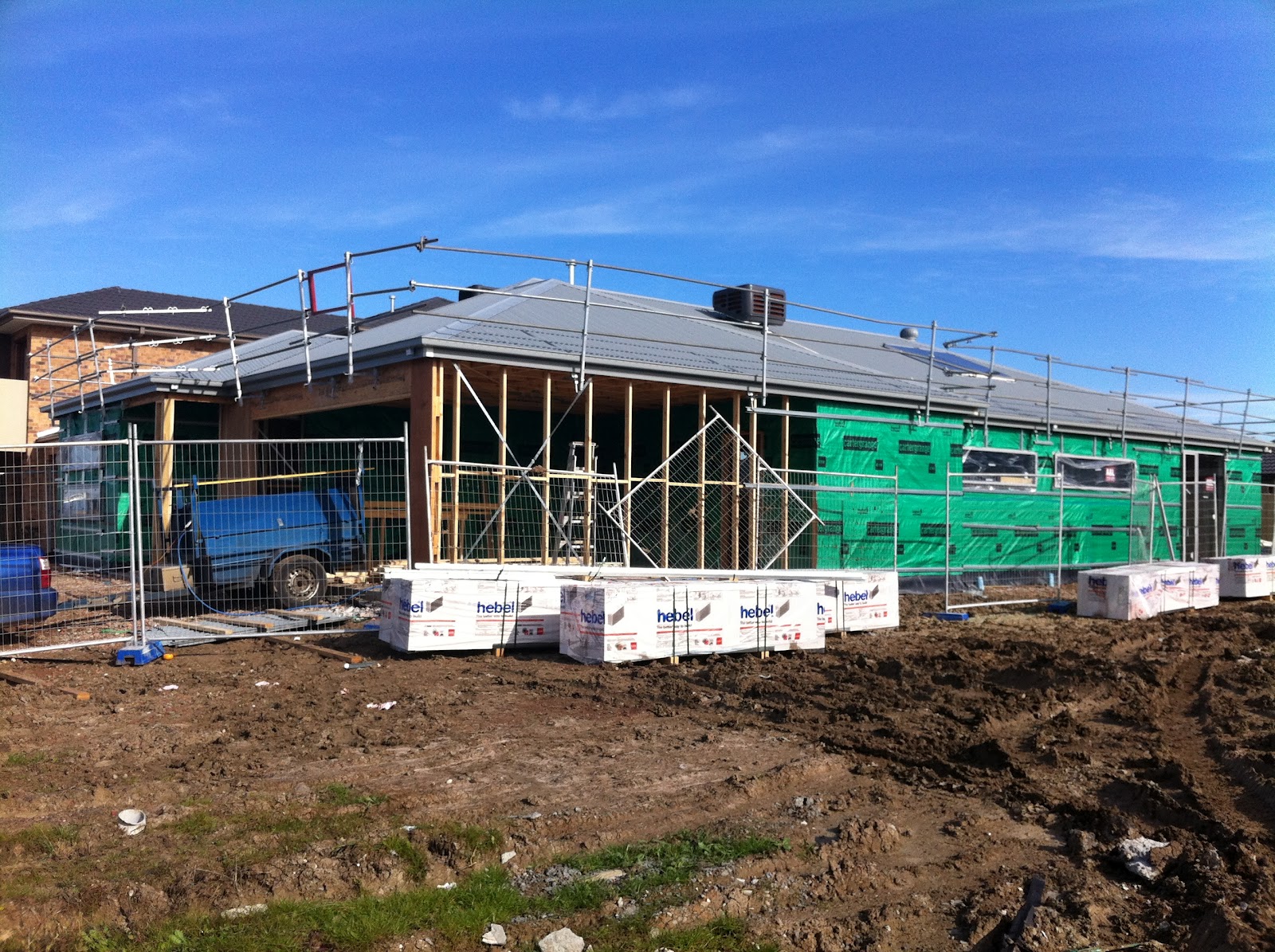

Week 8 04/06/12: electrics finished, internal doors hung, hebel started.
Week 9 11/06/12: hebel continues, insulation and plaster done
